TOLOGIX - ISLG App Rebuild

Outstanding User Stories from Past Releases

Hi Ketan Sondarva, Technical Project Manager at DevIT Ketan ,

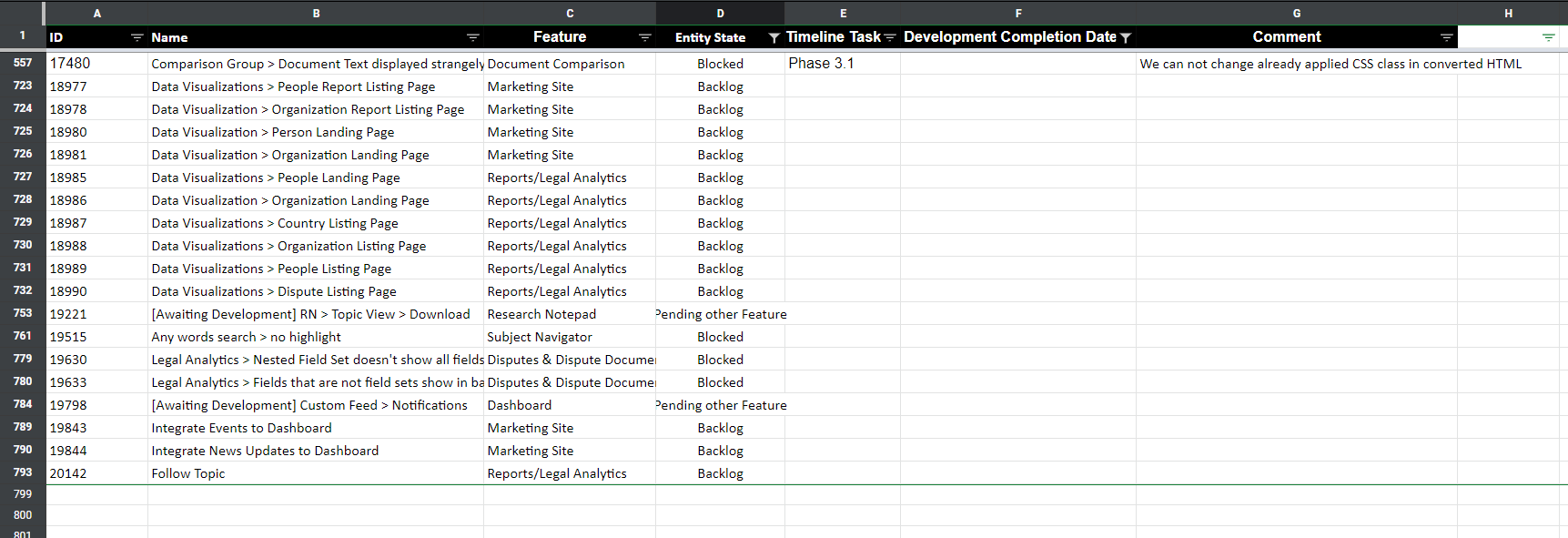

Reviewing the last update in the timeline: https://docs.google.com/spreadsheets/d/1ArmqOfOLDeME0i1OzrnyueIDa6_Xam4P_nZ1ddv5dW8/edit#gid=0, there is following user stories outstanding from past releases:

ISLG Release 2: 30 September 2020
ISLG Release 3: 31 October 2020
ILG Release 4: 31 October 2020

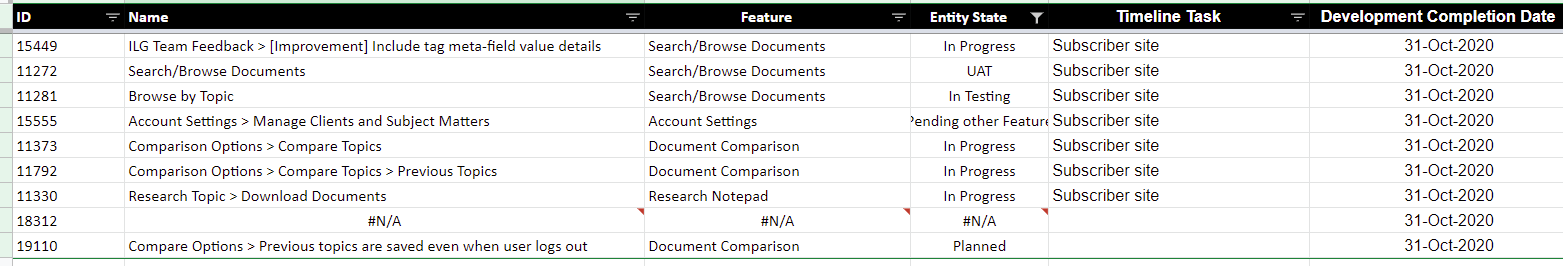

With the exception of 11272, which is currently in UAT, all the user stories above need to be reassigned to different release dates by updating the Development Completion Date in the spreadsheet. Could you please update the dates accordingly and we'll ensure these past releases can be removed from the timeline.

Thanks,

Morgan

Comments & Events

Morgan Maguire, CEO
Hi Ketan Sondarva, Technical Project Manager at DevIT Ketan ,

In addition to the above, there are number of user stories in ISLG Admin and ISLG Subscriber that need to be assigned to the appropriate Development Completion Dates:

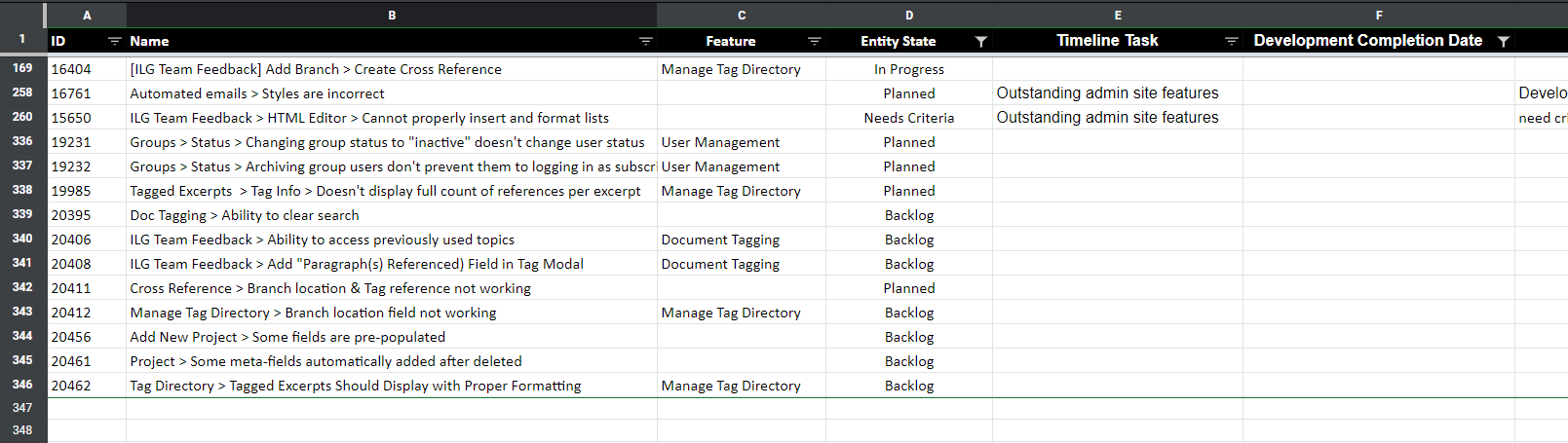

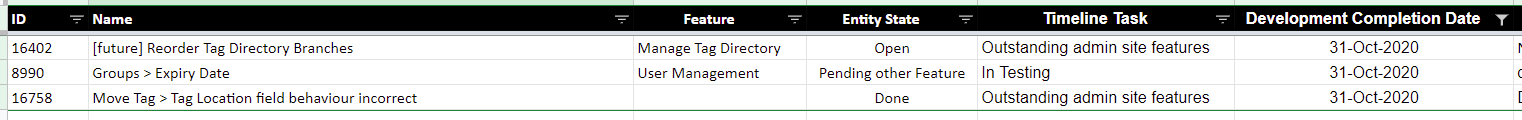

ISLG Admin:

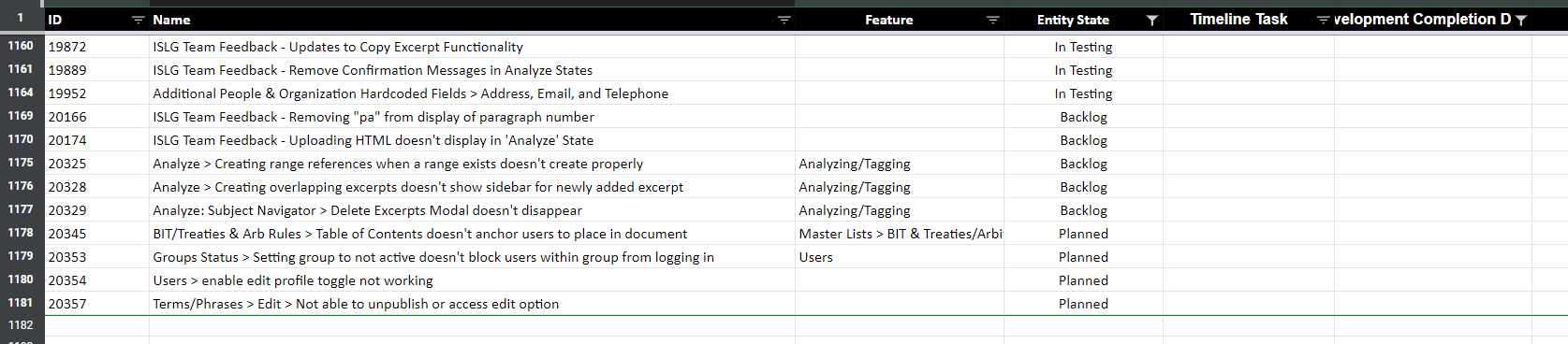

ISLG Subscriber:

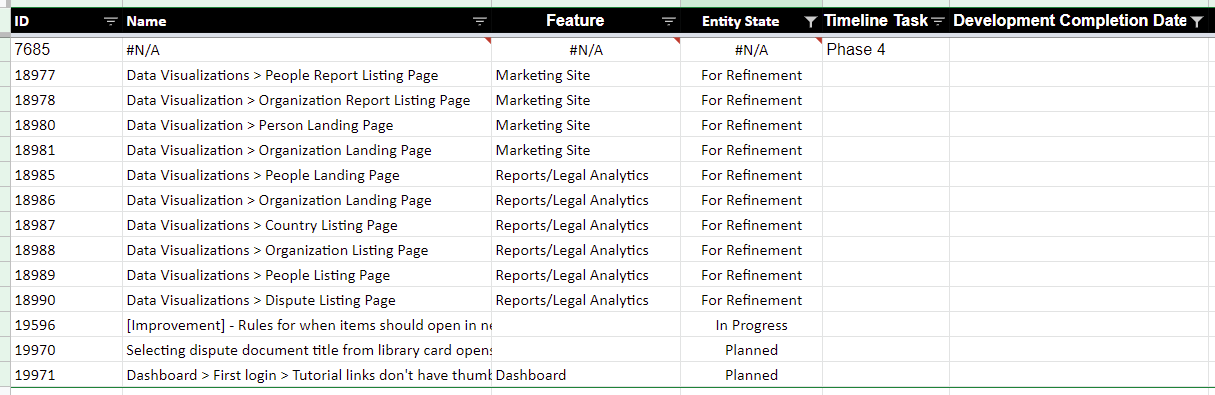

Savannah Mitchell, Project Manager at Industrial Savannah , note that the Data Visualization user stories are still in "For Refinement" status, and need their requirements finalized. I've added these to the agenda for discussion tomorrow, so that the Ketan Sondarva, Technical Project Manager at DevIT Ketan can get these integrated into the timeline.

Thanks,

Morgan
Savannah Mitchell, Project Manager at Industrial
Melissa Cowell, General Manager at Industrial Melissa
Morgan Maguire, CEO
Hello Melissa Cowell, General Manager at Industrial Melissa , Savannah Mitchell, Project Manager at Industrial Savannah and Ketan Sondarva, Technical Project Manager at DevIT Ketan ,

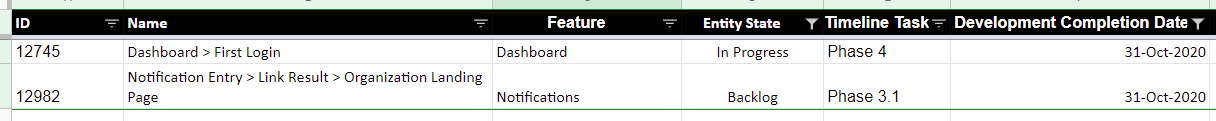

Following up on above, for ISLG all the user stories for Release 2 are complete; however, there are still 3 user stories from Release 3 outstanding. I have inserted specific comments into TargetProcess as required.

Regarding outstanding user stories that have not been assigned a Development Completion Date, the updated user stories are the following:

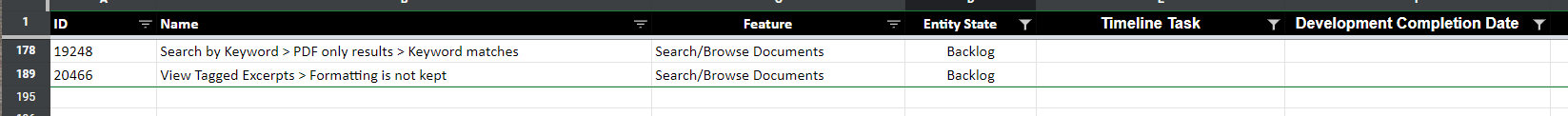

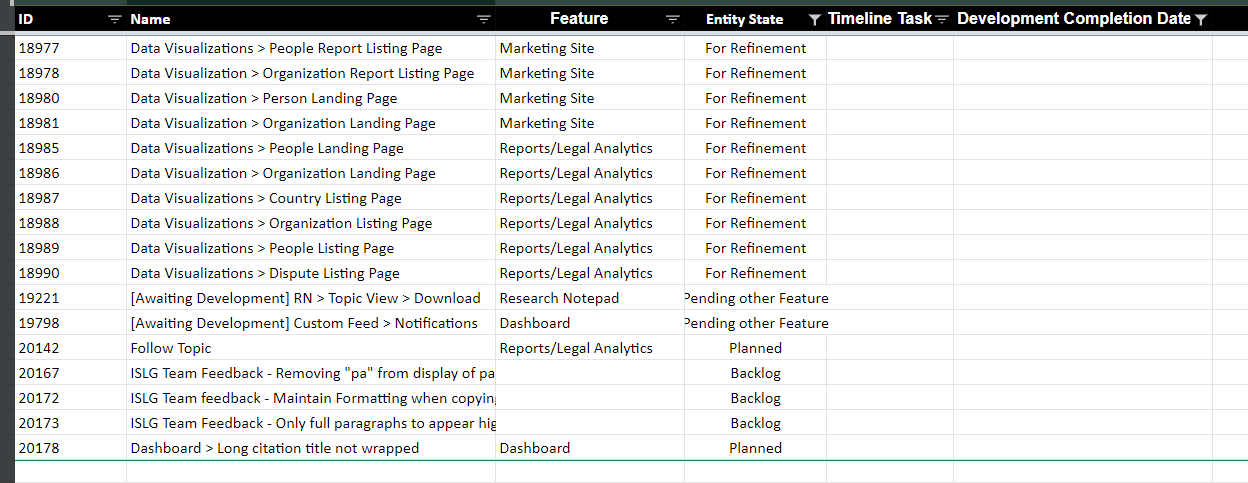

ISLG Admin:

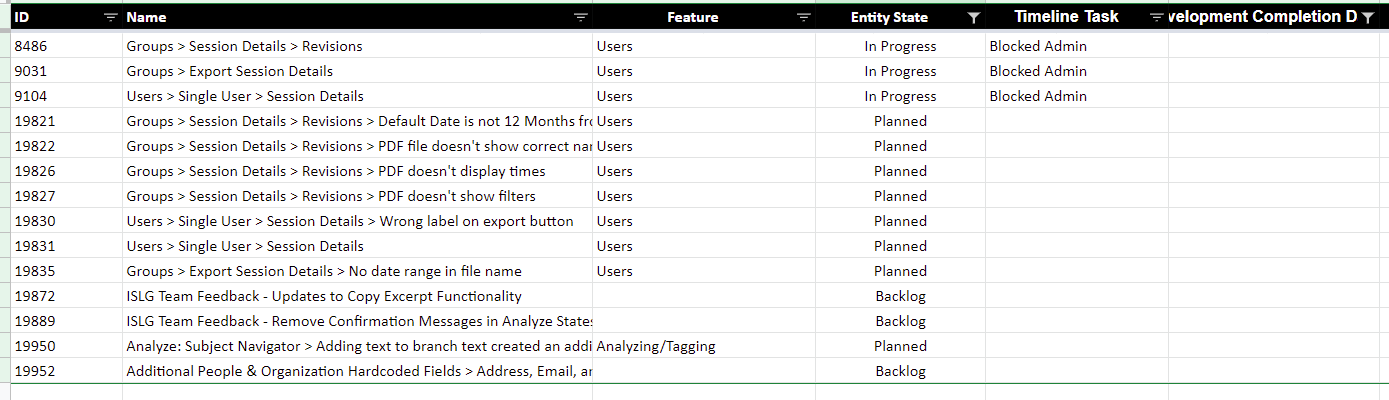

ISLG Subscriber:

Ketan Sondarva, Technical Project Manager at DevIT Ketan , could you please ensure all the user stories above are assigned Development Completion Dates.

Melissa Cowell, General Manager at Industrial Melissa , could you please ensure user stories in "Peer Review" or "For Refinement" are finalized and moved into the Backlog.

Regarding ISLG Releases 4 (October 31st) and 5 (November 30th), Ketan Sondarva, Technical Project Manager at DevIT Ketan could you please update the Development Completion Dates for these users as required. Taking into consideration the priority of completing the performance issue with the subscriber site for http://www.infrastructurelawguide.com: Subscribers Site - Performance Audit - TOLOGIX - Infrastructure LawGuide (ILG) for Tologix.

Thanks,

Morgan
